STRENGTHENING
OUR CATHEDRAL
THE CATHEDRAL BUILDING IS CLOSED FOR RESTORATION
St Mary's Sunday Services are held across the road at The Peace Hall. See our St Mary’s section for more information.
Earthquake-strengthening requirements led to the closure of the Cathedral building in 2016. Since then the community has come together and made significant progress towards the reopening of the building. This restoration project sparked a broader vision of reconciliation, one that extends beyond the physical restoration of the building and into the restoration of community, connection, and history.
As we approach a decade since the Cathedral building closed, we can look back at the incredible journey we have taken so far and feel proud of what we have accomplished. The opening of Te Whare Hononga and Te Manu Hononga / The Vicarage has been a true cause for celebration, and it has brought us all closer together. The restoration and reconciliation efforts have also strengthened our relationship with God. We remain hopeful for the future, knowing that the slow but solid journey we are on will lead us to a brighter tomorrow.
"The essence of a cathedral is that it belongs to the community and mirrors whatever makes that community rejoice or sorrow."
- Sir Paul Reeves
UPDATES & FAQS
-
-
A Detailed Seismic Assessment (DA) undertaken in 2014 by Holmes Consulting found Taranaki Cathedral to be an earthquake-prone building. In 2016 the Cathedral was closed due to strengthening requirements.
As a Category 1 Heritage building, all changes to the exterior of the church have to be approved by Heritage NZ and the New Plymouth District Council. The aim is to minimise the visual impacts of the strengthening by doing most of the work above the beautiful timber ceiling and within or under the stone walls. This requires careful and challenging deconstruction work and then reconstruction after the strengthening elements are added.
-
Taranaki Cathedral's church of St Mary is is listed as a Category 1 Heritage building, the oldest stone church in Aotearoa New Zealand, which sits in the heart of New Plymouth on the ancient site of Pūkākā Pā. The first stones for the church were laid in 1845 (much of which was sourced from Kawaroa reef). The stone is Taranaki Andesite, a volcanic rock from Taranaki Maunga, which makes the church a visual reminder of our shared history shaped by our local landscape, intrinsically linked to Taranaki and the stories of who we are, where we have come from and where we are going.
-
As we discussed the best solution to restrengthen and restore the Cathedral building, it became evident how important the building is for the community at large. We also came to understand that our shared history required more than just strengthening a building, there is an opportunity for restoration of the entire site. Our history on this land is deep and complicated, but our story began as a beautiful shared space with Mana Whenua and the first European settlers. Because of this, it was essential that we imagine and plan our site developments with Ngāti Te Whiti, keeping the broader objective of reconciliation at the forefront.
After many conversations, the project team planned the development of three connected buildings: The Cathedral, The Vicarage, and Te Whare Hononga. This project has been a catalyst for peace and reconciliation, community building, and collaboration.
In 2019 we began building Te Whare Hononga and restoring The Vicarage. These buildings were completed in early 2023 and are now a busy hub of learning and hospitality. Our restoration journey is underway!
The overall project is a total refocussing of the Cathedral which is made up of multiple aspects:
Turning the Cathedral site into an education resource of honest history and audacious hope
Moving and upgrading the Vicarage for Te Manu Hononga: Sir Paul Reeves Centre (completed in 2023)
Creating Te Whare Hononga to give visibility to Ngāti Te Whiti and provide exceptional education experience (opened to the Public April 2023)
The remediation of New Zealand’s oldest stone church – earthquake strengthened and designed to make the space more flexible and comfortable for contemporary worship and to reflect our bi-cultural journey. (Ongoing. Strengthening test on southern wall completed March 2024)
Phase 1 (Completed April 2023) Renovation of Vicarage; Building Te Whare Hononga; 2/3 of Exhibition Build.
Phase 2 (Ongoing) Strengthening (Remediation) of The Cathedral (Heritage 1 Building). In September 2023, we began a strengthening test on the southern wall of the Cathedral and was completed in March 2024. This test phase was a chance to de-risk the project for both us and the contractor, to get a far greater understanding of the work processes needed and to provide time for funds to be secured.
-
The renovation of the Vicarage and the building of Te Whare Hononga (Phase One) were completed before the Cathedral's church of St Mary was strengthened because we had the total funding to sign the contract for that phase. It meant work within the broader project could begin sooner, instead of delaying because of the need to secure funds for the total remediation budget. Also, a broader vision of reconciliation and education has been a large motivation behind much of the funds received to date, especially from TOI Foundation and the Crown. For instance, two million from Kānoa was given specifically for Phase One of the project.
The Cathedral remediation has been underway behind the scenes since 2016, with planning, consultation, consent and the strengthening test (which was $1.1m). As of March 2024, $2m has already been spent on Cathedral remediation.
-
The total cost of the project is $28.8m. The total cost of the project includes Te Whare Hononga, the Vicarage, the exhibition, professional fees, consents, the strengthening test and complete remediation of the Cathedral. Of that total cost, $21.4m is for the remediation of the Cathedral’s stone church of St Mary.
-
In 2019 early engineering solutions put the cost of strengthening the Cathedral in the order of $10m.
In 2023 we were advised that the cost to remediate the Cathedral had increased to $16m.
As of March 2024 the cost has increased from $16m to $21.4m. There are three principal reasons for the latest increase:
Completion of a strengthening test on the southern wall of the Cathedral has indicated a longer timeframe needed. More time = more money.
There have been inflationary-based increases in subcontractor pricing since 2023 by around 60% of the subcontractors.
One critical contractor increased their price by $700k.
As all funds needed for the project have not yet been secured, we cannot lock in the contractor’s March 2024 pricing offer. This means there is a possibility of further cost increases.
-
The two financial mechanisms we had in place in 2023 are now no longer options: a church trust underwrite of $6m is no longer available and the remaining cost is now too large for an immediate underwrite from another trust, but we have confirmed their commitment to a loan of $7m.
-
Taranaki Cathedral has been fortunate to receive funds from various sources over the years for the project, including the Anglican church, MBIE Kānoa, Toi Foundation, New Plymouth District Council, Lotteries & Heritage New Zealand, the George Mason Trust, and the wider Taranaki community. Taranaki Cathedral is deeply grateful to everyone who has contributed to date.
-
FUNDING RECEIVED
MBIE Kānoa - 2,751,150
Toi Foundation - 1,500,000
Wider Anglican Church - 3,000,000
Heritage and Lotteries - 500,000
NPDC Heritage Fund - 75,000
St. Mary’s Parish & NP Community - 1,758,600
St. Mary’s Parochial Trust - 300,000
Organ Fundraising - 59,400
Interest Received - 148,300FUNDS SECURED - NOT YET RECEIVED
MBIE Kānoa - 248,850 (for exhibition)
NPDC Heritage Fund - 150,000
Organ Pledge George Mason Trust - 50,000
Individual donors and pledges - 125,000
Wider Anglican Church loan - 7,000,000FUNDS SPENT & COMMITTED
Te Whare Hononga Build and Vicarage Renovation - 6,014,650
Exhibition - 1,000,000
Cathedral Remediation - 21,391,700
Overheads - 393,673 -
Gold Supporters: $100,000 +
Anonymous Donors +
Gavin & Carol Faull & Family
Jones and Sandford
Lotteries & Heritage
Provincial Growth Fund (Crown funding)
St John's College Trust Board
St Mary's Parochial Trust
Taranaki Cathedral Church of St Mary
Taranaki Daily News - supporter in kind
TSB Community Trust
Silver Supporters: $10,000 +
Anonymous Donors +
Anne Shipherd
Anne & Ross Smith
Anne Street
Bruce Wallis
Clelands Timber Products
C J Bright Accountant
Doug & Nancy Getson
Give a Little Donations
Helen and Monty Shearer
Jenny Goddard
John & Helen Armstrong
John & Karen Eagles
John & Margaret Young Family Trust
Julie & Geoff Otene
Louise, Richard, James & Daniel Chapman
Keith & Valerie Clarke
Memorium of Betty Byers
McCall Family
Margaret & Colin Comber
Rosemary & Peter Tennent & Family
Robert Angus
Sara & Bruce Binnie
Simcart Ltd
Simon Moseley
Staples Rodway Taranaki
Sue Pickering
TATB Trust
Tom Cassie
Warren & Claire BoltonBronze Supporters: $1000 +
Anonymous Donors +
Adrienne Ansley
Alan & Louise Knewstubb
Alison & BIll Thomas
Anne Macphail
Angevahn
Barbara Brockie
Betty Tuson
Bhakta Family
Brian & Carol Foy
Bruce & Di Richards
Bruce & Diane Hinton
Carla Brown
Caroline Blume
Catherine & Jim Lawn
Chaudhari Family Trust
Christine Cowley
Colin Carryer
Darryl Back
David & Gloria Williams
David & Sue Thorp
Elaine Gill
Elizabeth Davies
Eric Beardmore
Estate of Rosemary Ellis
Fred & Jo Cox
Foy Family
GD & BJ Miller
H A Hammond
Ian & Joan Mitchel
Ian Hutchinson
I W Morris
IK & PS McGill Family Trust
General Church Trust Board
Gymanfa Ganu 2018
Howard Vosper
Jamie Gemmell
JIm & Marlene Smale
Jen Pearce
Jenny Crowley
Jenny Floyd
Jennifer & Don Smart
Joan Sole
John Eagles
John & Pam Denney
John & Vicki Haylock
John Fairey
Judy Moratti
June Morris
June Moseley
Ken & Stancie Bruce
Leila Hunter
Lesa Bide
Lesley & Keith Lowe
Livingstone Builders
Lynn & Robin Bublitz
Madrigal Companie
Margaret & David Harrop
Mark Birch
Maureen Woodmore
Memoriam - Grace Mazey
Memorium - Robin & Hugh Moss
Memoriam - Monty Shearer
Memoriam - Joan Mitchell
Michael & Rosemary Bent
Nancy Jones
New Plymouth Bridge Club
Neil & Lynne Phillips
Ormond & Melva Greensill
Pamela Holdt
PAK n SAVE New Plymouth
Plymouth International Hotel
Prescott Family
Raynes Family
R Buchanan
R J Chapman
Raewyn & Neil Wolfe
RCW Richards
RG Cathie Family Trust
Rex and Jane Phillips
Richard Handley
Robert Richardson
Robert & Barbara Martin
Sandra Von de Vril
Shirley Dickson
Silent Auction
Sue & Rob McEwan
Sue Mower
Suzanne Porter
The Order of St Lazarus
Tim Harland
Weston, Webster & James Families
Supporters: $1 - $1000
Anonymous Donors +
A W Drake
AAW Fellowship
Adrienne & William Morton
Allan & Sue Chapman
Arene & Amanda Roche
Arthur Bowkett
AW & AJ Ansley
Bernice Frazerhurst
Bev Van Wynbergen
Blenheim Family
Breakfast Ladies
Bruno & Kathi Egli
Carol Hall
Carol Service
Cathedral Café
Cathedral Handbell Ringers
CF & VR McLeod
Christine Goode
Christine Thurston
Christopher & Joyce Backhouse
Colleen Rogers
CTW & EPM Henderson
David Giddy
David McCarthy
Denise & Tony Watts
Denise Baker
Denise Duncan
DH & JE Peterson
Diane Thorstensen
DN & JA Quickfall
Dorothy Lilly
E Webster
Euncie Reardon
FA Hardy
Fitzroy Rotary Club
Frank Wheeler
G Nauman
Garry Orr
George & Irene Voon
George Wall
Grant Burnett
Hazel Morey
Helen & Don Young
IF & BG Gregory
International Visitors
Ivan Morris
J B Sinclair
J M Webley
Jennifer Jones
Jenny Crowley
Jill MacInnes
JM & JH Strawbridge
Joan Willison
John & Avery Fathers
John Darke
Joy Edlin
Judith Lamb
Judy Webley
Julie Clement
K R Emmerson
L A Kemsley
L Lehndorf
Lee Balsom
LLoyd & Jan McDell
Lorna Martin
Lyn Kretchmar
Lyndon Francis
Lynn O'Keeffe
M & N Des Forges
M Hogwood
Macey Allen
Margot Crate
Marion Beamish
Mary Harker
Mary Hogwood
Mary Washer
May Coulton
Memoriam - Doris Ridland
Memoriam - Ian Hughson
Memoriam - Ian Mitchell
Memoriam - Ivor Wesley
Memoriam - Kuni Hansen
Memoriam - Lloyd Horn
Memoriam - Rosemary Ellis
Memoriam - Don Brown
Morris & Lynda West
Naomi Ward
National Youth AD
NR & LM Hogwood
NR & ML Hogwood
P G Sacree
P J Ansford
P S Brightwell
Patricia & Walter Garrett
Paul Moroney
Peter & Shona Wright
Peter Egli
Peter Woodhead
R J Newton
Raewyn & Neil Wolfe
Raewyn Wolfe
Ralph & Janice West
Ralph Ward
Ray Gedye
Rob Green
Robert Mahy
Rochelle West & Warrick Quinn
Rosalie Peters
Ross & Jane Dingle
Rotary Club of Fitzroy
Ruth McLeod
Sandra Parry
SG & BP Fleming
Shirley Fougere
Shirley Lobb
Shona Patterson
Sigurdsson Family Trust
St Chads Ladies Fellowship
St Mary's Mothers' Union
St Mary's Womens Fellowship
Sue Harrop
Susan Mahy
T J McInally
Taranaki Country Womens Institute
Taranaki Women's Club
The Victoria League
Tom Prout
Victor & Michelle Lucibella
Wayne Manning
Wilson Family Reunion
Wilson Family Trust
Wolfe Pack -
As of March 2024, St Mary’s Parish, the New Plymouth Community and other individuals have donated $1,758,600. Those funds have been used to start the remediation work on the Cathedral’s Heritage 1 building. Donations received for the stain-glass windows and organ restoration have been set aside for that purpose.
Note:
Professional fees and consents (incurred since 2016) across the total project come to $1.3mAs of Februrary 2024 over 2 million dollars has been spent specifically on the Cathedral remediation.

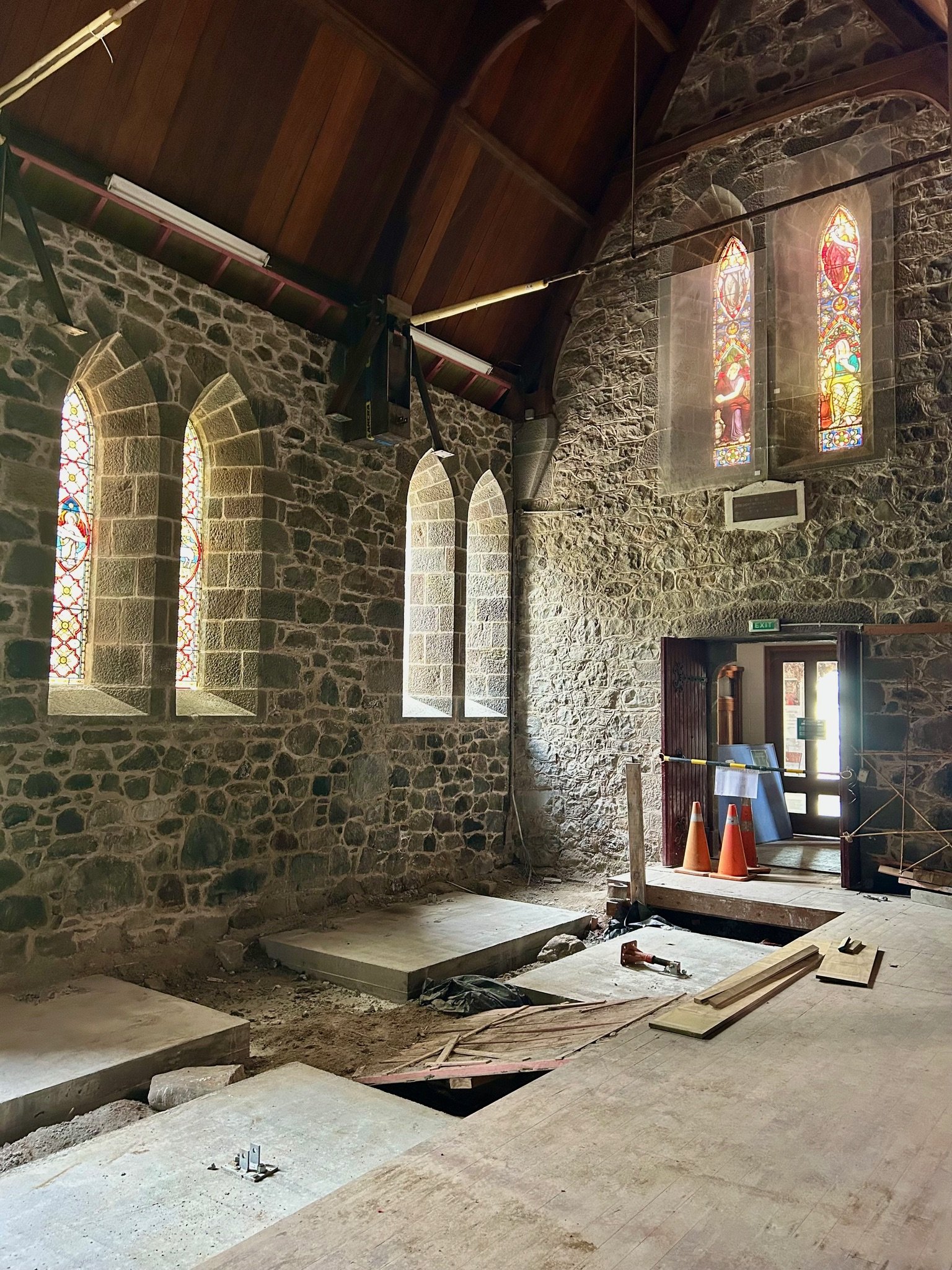

As of March 2024, the strengthening test of the cathedral building has cost $700,000, with a total expected cost of $1.1m once invoicing is finally submitted and paid.
-
The Cathedral’s stone walls are comprised of an inner and outer layer, with a space between that is filled with loose rubble or stone offcuts. Overall the walls are typically 750mm (30") thick. There are no reinforcing or steel bars linking the stones together or the inner layer to the outer layer. This sort of construction is referred to as Unreinforced Masonry (URM) and creates unique problems for engineers.
Strengthening the walls involves a specialised grout being injected into the cavity between the massive walls to strengthen them. Pins are then inserted within the thick stone walls into new concrete foundations. The buttresses are pinned through to the central core of the walls and a concrete beam is poured along the top of the stone walls with fixings to connect the timber trusses to the walls.
Additional foundation work must be done alongside and under the walls at the eastern end. Careful hand excavation will be required to minimise ground disturbance.
The existing slates must be removed from the roof to allow a plywood sheet diaphragm to be fixed in place over the timber ceiling. A web of steel frames will be laid over the existing timber trusses before a new slate roof is installed. The new roof will end up 40mm higher - hardly noticeable to the naked eye but needing careful detailing at the gutter and gable ends.
After the work is done the sanctity of Taranaki Cathedral will be enhanced, with sensitive strengthening and interior modifications - designed to make the space more flexible and comfortable for contemporary worship and to reflect our bi-cultural journey. Taranaki Cathedral would like to extend special thanks to Clelands for their support, commitment to the project and their successful work thus far.
-
The current funding effort is to complete the Phase 2 work of remediation, deferred maintenance, and upgrade of the Cathedral. Our current funds leave us $11.25m short and we cannot continue Phase 2 until these funds are secured.
We are communicating with funders regarding the pause of Phase 2 and working with them individually on next steps.
-
In 2021, The Taranaki Anglican Trust Board (TATB) began The Project by renovating the vicarage and building Te Whare Hononga. At the time, there were insufficient funds to undertake the remediation of the Cathedral.
In September 2023 remediation work began on the Cathedral. With the experience of the strengthening test completed March 2024, the contractor now feel there is at least a minimum of 24 months of work remaining to complete the work on the Cathedral. The remaining work is not able to be done until we raise the funds to cover the budget shortfall. We are working to secure funds so that the Cathedral’s remediation (Phase 2) can continue by April 2026 subject to contractor availability, with the hope of the projection completed by May 2028.
April 2024 to April 2025:
- Continue the conversation with key church organisations to secure pathways for funding
- Continue to develop Taranaki Cathedral’s commitment to peace and reconciliation through our Treaty-inspired governance and working with iwi.
- Continue to develop the educational work of Te Manu Hononga: Sir Paul Reeves CentreApril 2025 to April 2026:
- Confirm sources of funding
- Project a date to continue the remediation work -
The Cathedral Remediation Project Management Group (PMG) exists with delegated authority from the governing body of the Taranaki Cathedral (“the Commission”) and reports monthly in that capacity. Activity levels of the PMG will continue to be assessed as the funding process develops.
The PMG membership consists of:
John Eagles, Chair, Taranaki Anglican Trust Board (TATB)
Jenny Goddard, Former Project Manager
Barbara Brockie, Treasurer & Secretary
Graeme Fairclough, Ngāti te Whiti representative
Julie Otene, Parish representative
Very Rev. Jay Ruka, Dean, Taranaki Cathedral
Rev. Dan Lander, Precentor, Taranaki Cathedral
Frances Brown, Operations Manager, Taranaki Cathedral
-
Peace Complex (Across the street from the Cathedral)
- There has been no further update from the NPDC as to the heritage status potential of the Peace complex. We will continue to gather as a community with the regular Sunday services in the Peace Hall and other activities in the Peace Lounge. The St Mary’s Op Shop remains open.Hatherly Hall
- Vivian Street driveway will be sealed and Hatherly Hall will be reopened for use until the work to earthquake-strengthen the Cathedral can continue. The reception office is still located downstairs, with access from the courtyard. The upstairs chapel is used for mid week services.
